Project

General

Profile

Gantt

Filters

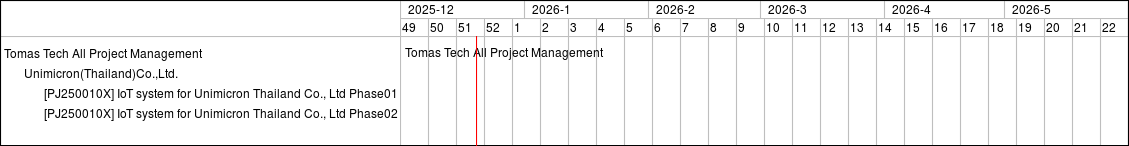

Zoom in Zoom out « June | August »

months from Apply Clear

Parent project #3346: [PJ2500104] IoT system for Unimicron(Thailand)Co., Ltd Phase01
Project progress work #4349: [Requirement definition]
Project progress work #6623: [Requirement definition] Software development
Project progress work #4350: [Internal Design]
Project progress work #4352: [Installation&On-site support]
Parent project #3347: [PJ2500104] IoT system for Unimicron(Thailand)Co., Ltd Phase02
Project progress work #4353: [Requirement definition]
Project progress work #6639: [Requirement definition] Software development
Project progress work #6640: [Requirement definition] Software service application development
Project progress work #4354: [Internal Design]
Project progress work #6641: [Internal design] System Design
Project progress work #4356: [Installation&On-site support]

Status

In Progress
In Progress
New
New
New
New
In Progress
New
New
New
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

2004.00
736.00
600.00
208.00
460.00
2012.00
736.00
600.00
448.00
216.00
460.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

19 Jun 2026 14:51
08 Apr 2026 10:44
13 Feb 2026 15:14
25 Apr 2026 13:34
19 Jun 2026 14:51
19 Jun 2026 14:52
19 Jun 2026 14:54
08 Apr 2026 10:45
13 Feb 2026 15:44
13 Feb 2026 15:46
25 Apr 2026 13:39
13 Feb 2026 15:48
19 Jun 2026 14:54
19 Jun 2026 14:53


28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
45
46
47
48
49
50
51
52
Tomas Tech All Project Management
UNIMICRON (THAILAND) CO., LTD.
In Progress
In Progress 83%
New 0%
New 100%
New 99%
New 100%
In Progress
New 71%
New 0%
New 0%
New 85%
New 80%
New 100%
New 100%
