Project

General

Profile

Gantt

Filters

Zoom in Zoom out « January | March »

months from Apply Clear

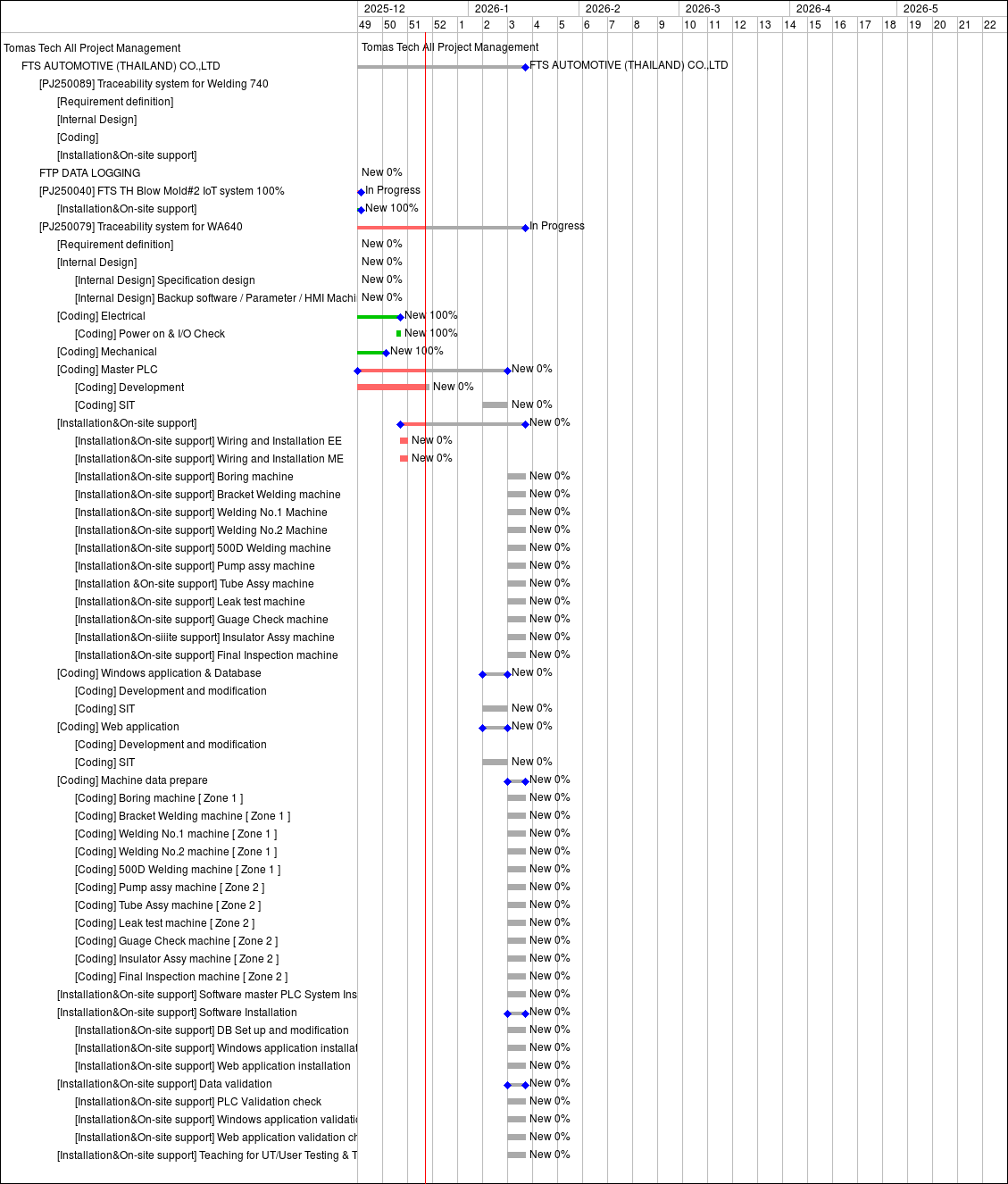

Project progress work #764: FTP DATA LOGGING
Parent project #1279: [PJ250040] FTS TH Blow Mold#2 IoT system 100%
Project progress work #1283: [Installation&On-site support]
Parent project #2807: [PJ250079] Traceability system for WA640
Project progress work #3207: [Coding] Electrical
Project progress work #3215: [Coding] Power on & I/O Check
Project progress work #3208: [Coding] Mechanical
Project progress work #2810: [Coding] Master PLC
Project progress work #3185: [Coding] Development
Project progress work #3222: [Installation&On-site support]
Project progress work #3224: [Installation&On-site support] Wiring and Installation ME
Project progress work #3225: [Installation&On-site support] Boring machine
Project progress work #3226: [Installation&On-site support] Bracket Welding machine
Project progress work #3227: [Installation&On-site support] Welding No.1 Machine
Project progress work #3228: [Installation&On-site support] Welding No.2 Machine
Project progress work #3229: [Installation&On-site support] 500D Welding machine
Project progress work #3230: [Installation&On-site support] Pump assy machine
Project progress work #3231: [Installation &On-site support] Tube Assy machine
Project progress work #3232: [Installation&On-site support] Leak test machine
Project progress work #3233: [Installation&On-site support] Guage Check machine
Project progress work #3234: [Installation&On-siiite support] Insulator Assy machine
Project progress work #3235: [Installation&On-site support] Final Inspection machine
Project progress work #3187: [Coding] Windows application & Database
Project progress work #3188: [Coding] Development and modification
Project progress work #4430: [Coding] Update software and DB for new model
Project progress work #3190: [Coding] Web application
Project progress work #3193: [Coding] Machine data prepare
Project progress work #3194: [Coding] Boring machine [ Zone 1 ]
Project progress work #3195: [Coding] Bracket Welding machine [ Zone 1 ]
Project progress work #3196: [Coding] Welding No.1 machine [ Zone 1 ]
Project progress work #3197: [Coding] Welding No.2 machine [ Zone 1 ]
Project progress work #3198: [Coding] 500D Welding machine [ Zone 1 ]
Project progress work #3199: [Coding] Pump assy machine [ Zone 2 ]
Project progress work #3200: [Coding] Tube Assy machine [ Zone 2 ]
Project progress work #3201: [Coding] Leak test machine [ Zone 2 ]
Project progress work #3202: [Coding] Guage Check machine [ Zone 2 ]
Project progress work #3203: [Coding] Insulator Assy machine [ Zone 2 ]
Project progress work #3204: [Coding] Final Inspection machine [ Zone 2 ]
Project progress work #3236: [Installation&On-site support] Software master PLC System Installation
Project progress work #3237: [Installation&On-site support] Software Installation
Project progress work #3238: [Installation&On-site support] DB Set up and modification
Project progress work #3239: [Installation&On-site support] Windows application installation
Project progress work #3240: [Installation&On-site support] Web application installation
Project progress work #4431: [Installation&On-site support] Software and DB for new model installation
Project progress work #3241: [Installation&On-site support] Data validation
Project progress work #3242: [Installation&On-site support] PLC Validation check
Project progress work #3243: [Installation&On-site support] Windows application validation check
Project progress work #3244: [Installation&On-site support] Web application validation check
Project progress work #3245: [Installation&On-site support] Teaching for UT/User Testing & Trial/Supports user feedback
Parent project #2812: [PJ250089] Traceability system for Welding 740
Project progress work #2813: [Requirement definition]
Project progress work #2814: [Internal Design]
Project progress work #4432: [Coding] Update software and DB for new model
Project progress work #2816: [Installation&On-site support]
Project progress work #4433: [Installation&On-site support] Software and DB for new model installation

Status

New
In Progress
New
In Progress
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
In Progress
New
New
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

300.00
1088.00
944.00
1656.00
288.00
8.00
184.00
160.00
120.00
40.00
296.00
16.00
40.00
40.00
40.00
40.00
40.00
40.00
40.00
120.00
40.00
80.00
40.00
40.00
400.00
40.00
40.00
40.00
40.00
40.00
40.00
40.00
40.00
40.00
40.00
80.00
40.00
0.00
120.00
80.00
80.00
40.00
40.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

16 Nov 2024 10:43
18 Dec 2025 15:56
18 Dec 2025 15:56
22 Jan 2026 13:10
13 Dec 2025 13:17
13 Dec 2025 13:17
13 Dec 2025 13:17
22 Jan 2026 10:57
22 Jan 2026 10:57
22 Jan 2026 10:57
22 Jan 2026 11:48
16 Jan 2026 11:04
17 Jan 2026 13:41
22 Jan 2026 11:15
22 Jan 2026 11:47
22 Jan 2026 11:47
22 Jan 2026 11:47
22 Jan 2026 11:47
22 Jan 2026 11:47
22 Jan 2026 11:47
22 Jan 2026 11:48
22 Jan 2026 11:48
22 Jan 2026 11:48
22 Jan 2026 11:16
22 Jan 2026 11:16
17 Jan 2026 13:42
16 Jan 2026 11:03
22 Jan 2026 13:10
22 Jan 2026 11:14
22 Jan 2026 11:48
22 Jan 2026 11:14
22 Jan 2026 11:14
22 Jan 2026 11:14
22 Jan 2026 11:14
22 Jan 2026 11:14
22 Jan 2026 11:46
22 Jan 2026 11:47
22 Jan 2026 11:47
22 Jan 2026 11:48
22 Jan 2026 11:48
22 Jan 2026 11:48
22 Jan 2026 11:48
22 Jan 2026 11:49
22 Jan 2026 11:48
22 Jan 2026 11:49
22 Jan 2026 11:49
16 Jan 2026 11:05
22 Jan 2026 13:10
22 Jan 2026 13:09
22 Jan 2026 13:10
22 Jan 2026 13:10
11 Dec 2025 15:35
16 Jan 2026 11:07
03 Nov 2025 13:08
03 Nov 2025 13:08
16 Jan 2026 11:07
16 Jan 2026 11:07
16 Jan 2026 11:07
16 Jan 2026 11:07


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
Tomas Tech All Project Management
FTS AUTOMOTIVE (THAILAND) CO.,LTD
New 0%
In Progress
New 100%
In Progress
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 55%
New 100%
New 100%
New 0%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 100%
New 75%
New 100%
New 100%
New 100%
New 0%
New 100%
New 100%
New 100%
New 100%
New 0%
In Progress
New 0%
New 0%
New 0%
New 0%


Also available in: PDF PNG
