Project

General

Profile

Gantt

Filters

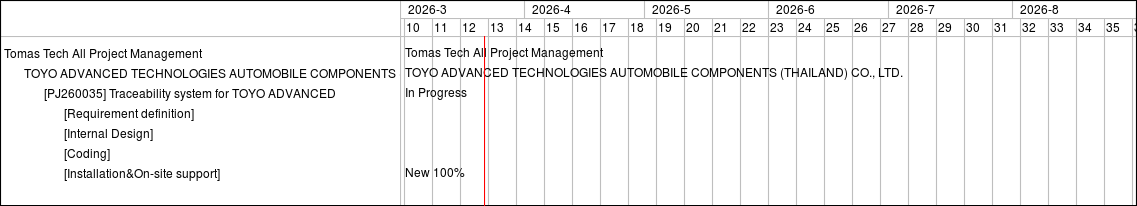

Zoom in Zoom out « May | July »

months from Apply Clear

Status

In Progress
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal

Assignee

Total estimated time

1360.00
128.00
16.00
216.00
1000.00

Total spent time

0.00
0.00
0.00
0.00
0.00

Updated

19 Jun 2026 16:02
17 Jun 2026 16:35
02 Apr 2026 09:39
26 May 2026 13:18
19 Jun 2026 16:02

23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
45
46
47
48
Tomas Tech All Project Management


TOYO ADVANCED TECHNOLOGIES AUTOMOBILE COMPONENTS (THAILAND) CO., LTD.




In Progress
Parent project #6731: [PJ260035] Traceability system for TOYO ADVANCED

Project: TOYO ADVANCED TECHNOLOGIES AUTOMOBILE COMPONENTS (THAILAND) CO., LTD.
Status: In Progress
Start date: 17 Feb 2026
Due date: 18 Jun 2026
Assignee: Nattapol Poeam
Priority: Normal




New 100%
Project progress work #6740: [Installation&On-site support]

Project: TOYO ADVANCED TECHNOLOGIES AUTOMOBILE COMPONENTS (THAILAND) CO., LTD.
Status: New
Start date: 17 Feb 2026
Due date: 11 Jun 2026
Assignee:
Priority: Normal
New 100%
New 100%




New 100%
Project progress work #6739: [Coding]

Project: TOYO ADVANCED TECHNOLOGIES AUTOMOBILE COMPONENTS (THAILAND) CO., LTD.
Status: New
Start date: 20 Apr 2026
Due date: 18 Jun 2026
Assignee:
Priority: Normal


Also available in: PDF PNG
