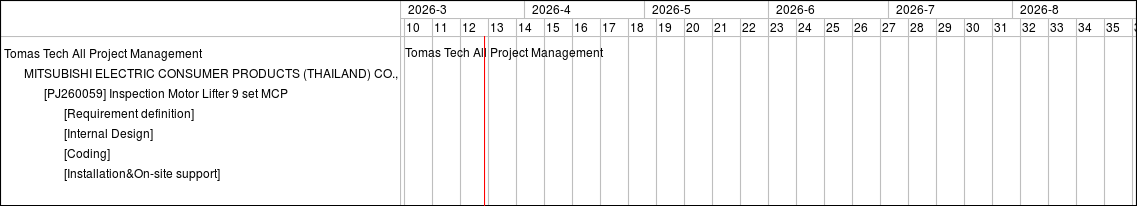

Project

General

Profile

Gantt

Filters

Zoom in Zoom out « July | September »

months from Apply Clear

Parent project #7122: [PJ260069] MCP_Belt Conveyor B,G-Line_Installation
Project progress work #7123: [Requirement definition]
Project progress work #7124: [Internal Design]
Project progress work #7126: [Installation&On-site support]
Parent project #8202: [PJ260083] MCP_Installation C-Line_Installation
Project progress work #8203: [Requirement definition]
Project progress work #8204: [Internal Design]
Project progress work #8206: [Installation&On-site support]
Parent project #8589: [PJ260116] Modify Guide for Conveyor test room D-Line
Project progress work #8590: [Requirement definition]
Project progress work #8591: [Internal Design]
Project progress work #8593: [Installation&On-site support]
Parent project #8688: [PJ260123] Inspection for Heavy Duty Lifter No.1-5
Project progress work #8689: [Requirement definition]
Project progress work #8690: [Internal Design]
Project progress work #8692: [Installation&On-site support]
Parent project #8693: [PJ260124] Inspection Motor Lifter 6 set for A,B,G Line
Project progress work #8694: [Requirement definition]
Project progress work #8695: [Internal Design]
Project progress work #8697: [Installation&On-site support]
Parent project #7023: [PJ260059] Inspection Motor Lifter 9 set MCP
Project progress work #7031: [Installation&On-site support]
Project progress work #7028: [Requirement definition]
Project progress work #7029: [Internal Design]
Parent project #8197: [PJ260082] Dismantle Slat Conveyor [U2-Line]
Project progress work #8198: [Requirement definition]
Project progress work #8199: [Internal Design]
Project progress work #8201: [Installation&On-site support]
Parent project #7117: [PJ260068] MCP_Belt Conveyor B,G-Line_Hardware
Project progress work #7121: [Installation&On-site support]
Project progress work #7119: [Internal Design]
Project progress work #7118: [Requirement definition]
Parent project #8207: [PJ260084] MCP_Installation C-Line_Hardware
Project progress work #8211: [Installation&On-site support]
Project progress work #8208: [Requirement definition]
Project progress work #8209: [Internal Design]

Status

In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

0.00
0.00
0.00
0.00
0.00
64.00
48.00
8.00
8.00
8.00
8.00
168.00
24.00
120.00
24.00
72.00
32.00
40.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

08 Apr 2026 09:56
08 Apr 2026 09:52
08 Apr 2026 09:53
08 Apr 2026 09:53
08 Apr 2026 09:53
07 May 2026 14:59
07 May 2026 14:59
07 May 2026 15:00
07 May 2026 15:00
07 May 2026 15:00
19 Jun 2026 10:07
19 Jun 2026 10:08
19 Jun 2026 10:08
19 Jun 2026 10:08
19 Jun 2026 10:08
29 Jun 2026 16:37
29 Jun 2026 16:29
29 Jun 2026 16:30
29 Jun 2026 16:30
29 Jun 2026 16:31
29 Jun 2026 16:49
29 Jun 2026 16:50
29 Jun 2026 16:50
29 Jun 2026 16:51
29 Jun 2026 16:51
05 Jun 2026 15:55
20 Mar 2026 15:41
06 May 2026 10:28
05 Jun 2026 15:55
26 May 2026 10:38
12 Jun 2026 16:20
07 May 2026 14:53
07 May 2026 14:53
07 May 2026 14:54
12 Jun 2026 16:20
20 Jun 2026 13:56
08 Apr 2026 09:51
12 Jun 2026 16:26
05 Jun 2026 16:02
20 Jun 2026 13:56
19 Jun 2026 16:39
07 May 2026 15:13
07 May 2026 15:14
19 Jun 2026 16:39
19 Jun 2026 16:35


32
33
34
35
36
37
38
39
40
41
42
43
44
45
46
47
48
49
50
51
52
53
1
2
3
4
Tomas Tech All Project Management
MITSUBISHI ELECTRIC CONSUMER PRODUCTS (THAILAND) CO., LTD.
In Progress
New 100%
New 100%
New 100%
In Progress
New 100%
In Progress
New 100%
New 100%
New 100%
In Progress
New 100%
New 100%


Also available in: PDF PNG
