Project

General

Profile

Gantt

Filters

Zoom in Zoom out « March | May »

months from Apply Clear

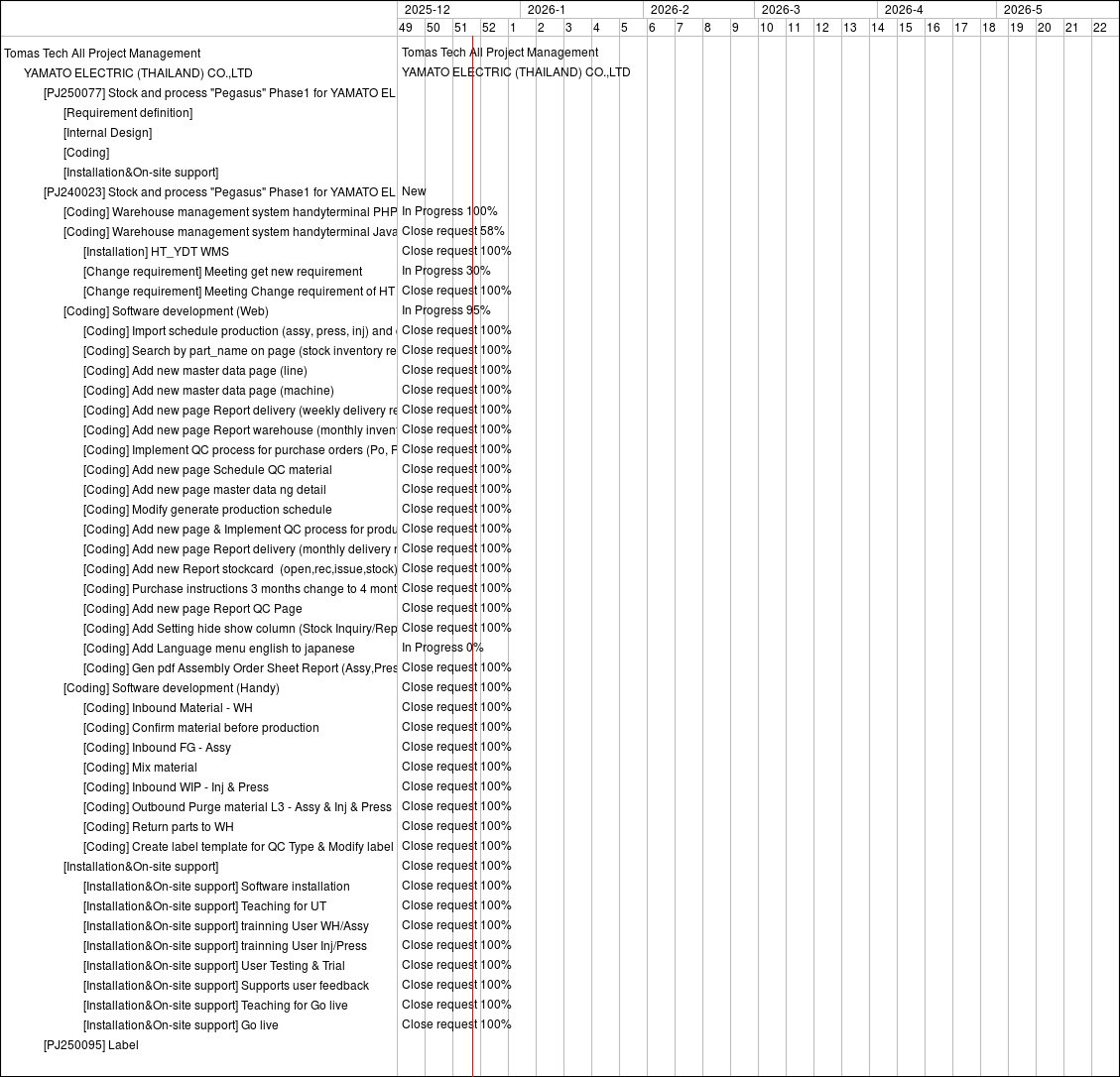

Parent project #592: [PJ240023] Stock and process "Pegasus" Phase1 for YAMATO ELECTRIC (THAILAND) CO.,LTD
Project progress work #1184: [Coding] Software development (Web)

Status

New
In Progress

Priority

Normal
Normal

Total estimated time

968.00
360.00

Total spent time

0.00

Updated

05 Mar 2026 16:27
05 Mar 2026 16:27


15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
Tomas Tech All Project Management
YAMATO ELECTRIC (THAILAND) CO., LTD.
New
In Progress 100%


Also available in: PDF PNG
