Project

General

Profile

Gantt

Filters

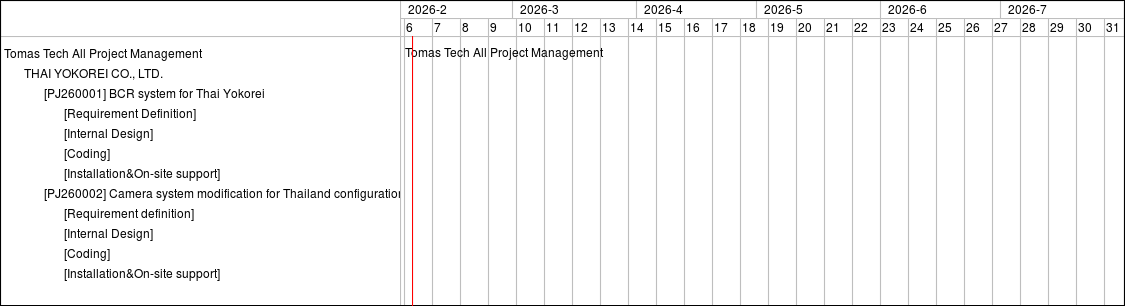

Zoom in Zoom out « March | May »

months from Apply Clear

Parent project #4384: [PJ260001] BCR system for Thai Yokorei
Project progress work #4441: [Requirement Definition]
Project progress work #4442: [Internal Design]
Project progress work #4444: [Installation&On-site support]
Parent project #4385: [PJ260002] Camera system modification for Thailand configuration BCR
Project progress work #4445: [Requirement definition]
Project progress work #4446: [Internal Design]
Project progress work #4448: [Installation&On-site support]

Status

In Progress
In Progress
New
New
New
In Progress
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

0.00
0.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

16 Jan 2026 14:32
16 Jan 2026 14:33
16 Jan 2026 14:33
16 Jan 2026 14:33
16 Jan 2026 14:33
16 Jan 2026 14:35
16 Jan 2026 14:35
16 Jan 2026 14:35
16 Jan 2026 14:35
16 Jan 2026 14:35


15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
Tomas Tech All Project Management


Also available in: PDF PNG
