Project

General

Profile

Gantt

Filters

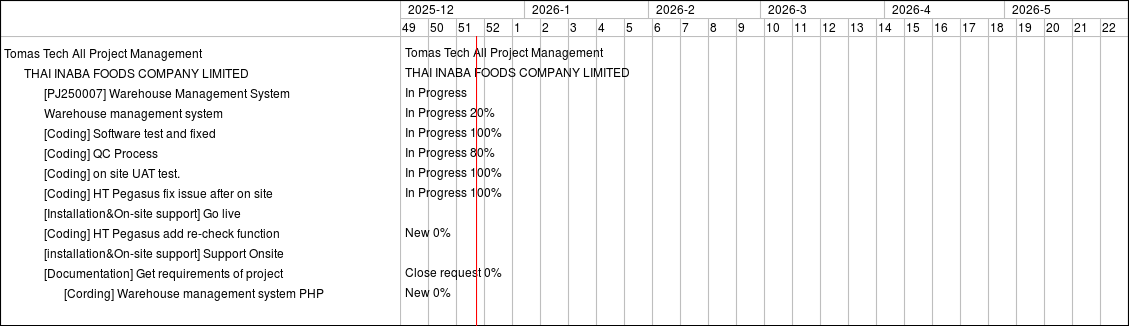

Zoom in Zoom out « April | June »

months from Apply Clear

Parent project #908: [PJ250007] Warehouse Management System
Project progress work #1005: Warehouse management system
Project progress work #1511: [Coding] QC Process
Project progress work #2865: [Installation&On-site support] Go live
Project progress work #2867: [Coding] HT Pegasus add re-check function
Project progress work #2878: [installation&On-site support] Support Onsite
Project progress work #871: [Documentation] Get requirements of project
Project progress work #1015: [Cording] Warehouse management system PHP

Status

In Progress
In Progress
In Progress
In Progress
New
In Progress
Close request
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

2140.00
480.00
40.00
80.00
16.00
340.00
300.00

Updated

06 May 2026 14:57
02 Jul 2025 17:45
07 Nov 2025 16:39
06 Nov 2025 16:15
06 Nov 2025 16:20
07 Nov 2025 16:48
04 Aug 2025 07:27
03 Jul 2025 16:21


19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
Tomas Tech All Project Management


THAI INABA FOODS COMPANY LIMITED



In Progress
Parent project #908: [PJ250007] Warehouse Management System

Project: THAI INABA FOODS COMPANY LIMITED
Status: In Progress
Start date: 10 Feb 2025
Due date: 06 May 2026
Assignee: Kittisak Isarapongporn
Priority: Normal
In Progress 20%
In Progress 80%
New 0%
Close request 0%
New 0%
