Project

General

Profile

Gantt

Filters

Zoom in Zoom out « April | June »

months from Apply Clear

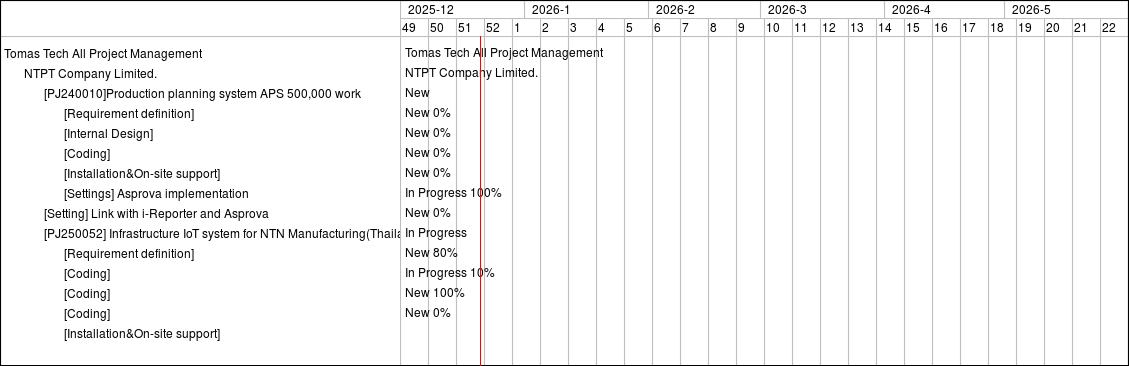

Parent project #537: [PJ240010]Production planning system APS 500,000 work
Project progress work #1143: [Requirement definition]
Project progress work #1144: [Internal Design]
Project progress work #1146: [Installation&On-site support]
Project progress work #673: [Settings] Asprova implementation
Project progress work #665: [Setting] Link with i-Reporter and Asprova
Parent project #1289: [PJ250052] Infrastructure IoT system for NTN Manufacturing(Thailand) NTPT
Project progress work #1298: [Requirement definition]
Project progress work #1304: [Installation&On-site support]

Status

New
New
New
New
In Progress
New
New
In Progress
New
New
New
New
New
In Progress

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

540.00
40.00
72.00
100.00
416.00
64.00
40.00
96.00
136.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

11 Mar 2026 16:07
12 Aug 2025 10:43
12 Aug 2025 10:43
12 Aug 2025 10:42
25 Dec 2024 18:28
11 Mar 2026 16:07
14 Jul 2024 15:50
30 Mar 2026 13:19
04 Sep 2025 14:42
16 Jan 2026 10:50
16 Jan 2026 10:49
22 Jan 2026 10:35
25 Mar 2026 15:19
30 Mar 2026 13:19


19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
Tomas Tech All Project Management
NTPT COMPANY LIMITED.
New
New 0%
New 0%
New 0%
In Progress 100%
New 100%
New 0%
In Progress
New 80%
New 60%
New 100%
New 100%
New 100%
In Progress 100%


Also available in: PDF PNG
