Project

General

Profile

Gantt

Filters

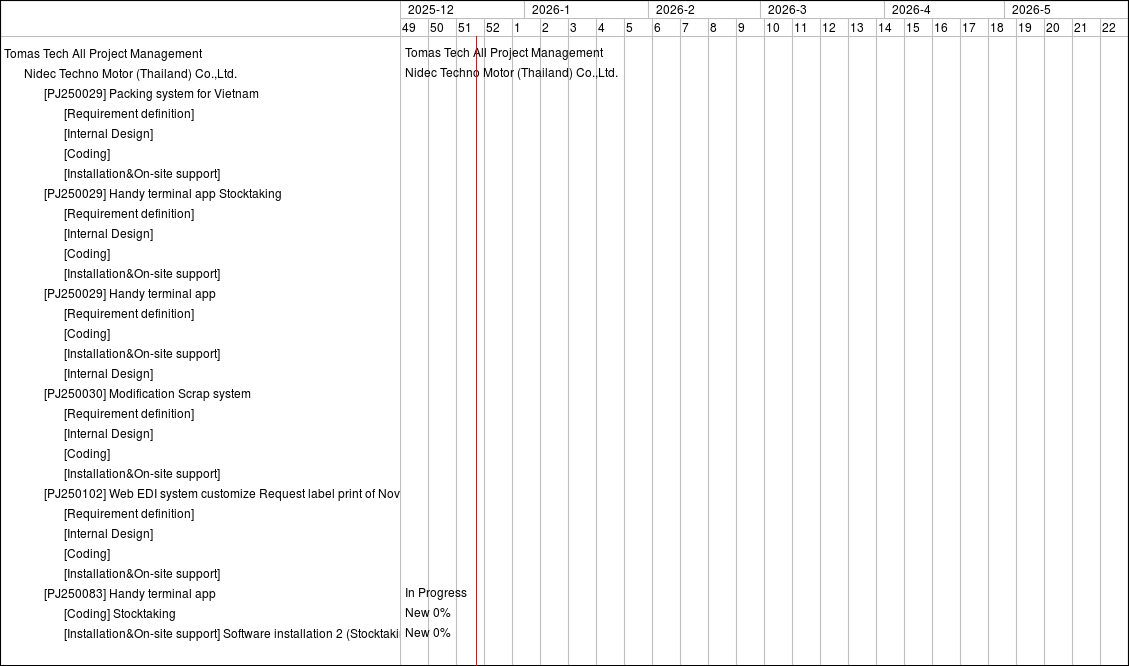

Zoom in Zoom out « January | March »

months from Apply Clear

Parent project #1635: [PJ250029] Packing system for Vietnam
Project progress work #1639: [Requirement definition]
Project progress work #1640: [Internal Design]
Project progress work #1642: [Installation&On-site support]
Parent project #1637: [PJ250029] Handy terminal app
Project progress work #1647: [Requirement definition]
Project progress work #1650: [Installation&On-site support]
Project progress work #1651: [Internal Design]
Parent project #3336: [PJ250102] Web EDI system customize Request label print of Nov.2025
Project progress work #3340: [Installation&On-site support]
Parent project #3390: [PJ2500107] Traceability system for NTMT RFID concept
Project progress work #3394: [Requirement definition]
Project progress work #3395: [Internal Design]
Project progress work #4363: [Internal Design] Software System Design
Project progress work #4364: [Internal Design] Hardware System Design
Project progress work #4365: [Internal Design] Hardware Drawing Design
Project progress work #4368: [Coding] Modify Pallet
Project progress work #4369: [Coding] Keyence Equipment
Project progress work #4370: [Coding] Hardware procurement
Project progress work #4366: [Coding] Software development
Project progress work #4372: [Coding] Hardware Assembly
Project progress work #4367: [Coding] Software test
Project progress work #4371: [Coding] Hardware pre-shipment confirmation
Project progress work #3397: [Installation&On-site support]
Project progress work #4373: [Installation&On-site support] Hardware installation and wiring
Project progress work #4374: [Installation&On-site support] Modification software machine
Project progress work #4375: [Installation&On-site support] Software installation
Project progress work #4376: [Installation&On-site support] Validation data
Project progress work #4377: [Installation&On-site support] Link gate Test with Server NTMT
Project progress work #4378: [Installation&On-site support] Teaching for UT
Project progress work #4379: [Installation&On-site support] User Testing & Trial
Project progress work #4380: [Installation&Onsite support] Supports user feedback
Project progress work #4381: [Installation&On-site support] Teaching for Go live
Project progress work #4382: [Installation&On-site support] Go live

Status

In Progress
New
New
New
New
In Progress
New
New
New
New
In Progress
In Progress
In Progress
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

0.00
0.00
24.00
1976.00
80.00
200.00
80.00
40.00
40.00
1096.00
320.00
176.00
280.00
200.00
40.00
40.00
40.00
600.00
40.00
40.00
80.00
40.00
40.00
80.00
80.00
80.00
80.00
40.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

01 Oct 2025 15:59
01 Oct 2025 15:58
01 Oct 2025 15:59
01 Oct 2025 16:00
01 Oct 2025 16:01
19 Nov 2025 11:04
01 Oct 2025 16:05
01 Oct 2025 16:07
01 Oct 2025 16:07
01 Oct 2025 16:10
26 Dec 2025 14:40
26 Dec 2025 14:49
17 Jan 2026 13:48
17 Jan 2026 13:48
07 Jan 2026 11:57
07 Jan 2026 11:57
07 Jan 2026 11:59
07 Jan 2026 11:59
07 Jan 2026 13:09
07 Jan 2026 13:09
07 Jan 2026 13:10
07 Jan 2026 13:11
07 Jan 2026 13:06
07 Jan 2026 13:14
07 Jan 2026 13:07
07 Jan 2026 13:13
07 Jan 2026 13:33
07 Jan 2026 13:15
07 Jan 2026 13:16
07 Jan 2026 13:17
07 Jan 2026 13:18
07 Jan 2026 13:19
07 Jan 2026 13:20
07 Jan 2026 13:23
07 Jan 2026 13:24
07 Jan 2026 13:26
07 Jan 2026 13:33


6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
Tomas Tech All Project Management

NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
In Progress



In Progress
Parent project #3390: [PJ2500107] Traceability system for NTMT RFID concept

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: In Progress
Start date: 05 Jan 2026
Due date: 26 Apr 2026
Assignee: Nattapol Poeam
Priority: Normal
New 100%
New 0%
New 0%
New 0%
New 0%



New 0%
Project progress work #3396: [Coding]

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 12 Jan 2026
Due date: 08 Mar 2026
Assignee: Nattapol Poeam
Priority: Normal


New 0%
Project progress work #4368: [Coding] Modify Pallet

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 12 Jan 2026
Due date: 08 Mar 2026
Assignee:
Priority: Normal


New 0%
Project progress work #4369: [Coding] Keyence Equipment

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 12 Jan 2026
Due date: 10 Feb 2026
Assignee:
Priority: Normal


New 0%
Project progress work #4370: [Coding] Hardware procurement

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 12 Jan 2026
Due date: 01 Mar 2026
Assignee:
Priority: Normal


New 0%
Project progress work #4366: [Coding] Software development

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 19 Jan 2026
Due date: 22 Feb 2026
Assignee:
Priority: Normal


New 0%
Project progress work #4372: [Coding] Hardware Assembly

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 02 Feb 2026
Due date: 08 Feb 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4367: [Coding] Software test

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 16 Feb 2026
Due date: 22 Feb 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4371: [Coding] Hardware pre-shipment confirmation

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 02 Mar 2026
Due date: 08 Mar 2026
Assignee:
Priority: Normal



New 0%
Project progress work #3397: [Installation&On-site support]

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 09 Mar 2026
Due date: 26 Apr 2026
Assignee: Nattapol Poeam
Priority: Normal

New 0%
Project progress work #4373: [Installation&On-site support] Hardware installation and wiring

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 09 Mar 2026
Due date: 15 Mar 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4374: [Installation&On-site support] Modification software machine

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 09 Mar 2026
Due date: 15 Mar 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4375: [Installation&On-site support] Software installation

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 09 Mar 2026
Due date: 22 Mar 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4376: [Installation&On-site support] Validation data

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 23 Mar 2026
Due date: 29 Mar 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4377: [Installation&On-site support] Link gate Test with Server NTMT

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 30 Mar 2026
Due date: 05 Apr 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4378: [Installation&On-site support] Teaching for UT

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 06 Apr 2026
Due date: 19 Apr 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4379: [Installation&On-site support] User Testing & Trial

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 06 Apr 2026
Due date: 19 Apr 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4380: [Installation&Onsite support] Supports user feedback

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 06 Apr 2026
Due date: 19 Apr 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4381: [Installation&On-site support] Teaching for Go live

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 06 Apr 2026
Due date: 19 Apr 2026
Assignee:
Priority: Normal

New 0%
Project progress work #4382: [Installation&On-site support] Go live

Project: NIDEC TECHNO MOTOR (THAILAND) CO., LTD.
Status: New
Start date: 20 Apr 2026
Due date: 26 Apr 2026
Assignee:
Priority: Normal


Also available in: PDF PNG
