Project

General

Profile

Gantt

Filters

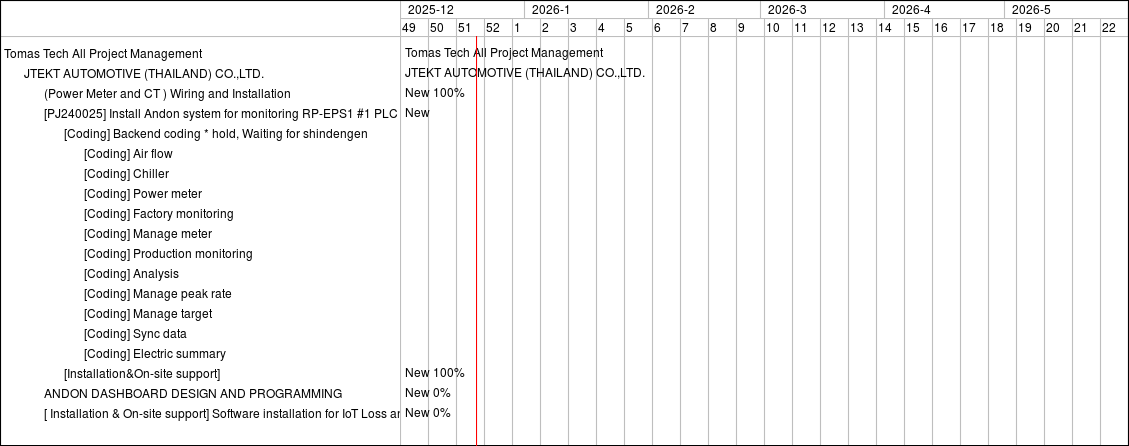

Zoom in Zoom out « April | June »

months from Apply Clear

Project progress work #614: (Power Meter and CT ) Wiring and Installation
Project progress work #763: ANDON DASHBOARD DESIGN AND PROGRAMMING
Project progress work #728: [ Installation & On-site support] Software installation for IoT Loss analysis MOC Line 1,2

Status

New
New
New

Priority

Normal
Normal
Normal

Total estimated time

348.00
600.00
200.00

Total spent time

Updated

16 Nov 2024 12:23
16 Nov 2024 10:43
16 Nov 2024 10:46


19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
40
41
42
43
44
Tomas Tech All Project Management
JTEKT AUTOMOTIVE (THAILAND) CO.,LTD.
New 100%
New 0%
New 0%


Also available in: PDF PNG
