Project

General

Profile

Gantt

Filters

Zoom in Zoom out « November | January 2026 »

months from Apply Clear

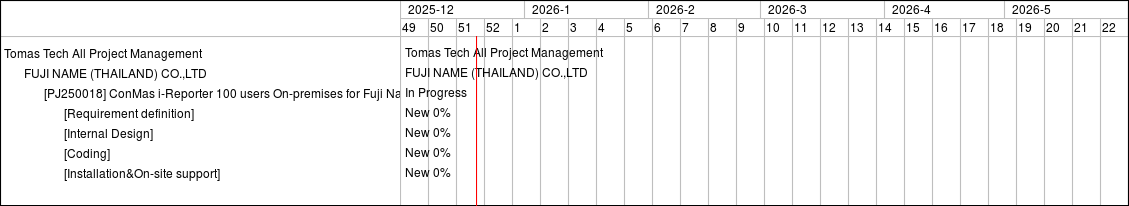

Parent project #1052: [PJ250018] ConMas i-Reporter 100 users On-premises for Fuji Name
Project progress work #1053: [Requirement definition]
Project progress work #1054: [Internal Design]
Project progress work #1056: [Installation&On-site support]

Status

In Progress
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal

Total estimated time

0.00

Total spent time

0.00
0.00
0.00
0.00
0.00

Updated

08 Sep 2025 17:36
06 Aug 2025 13:20
06 Aug 2025 13:22
06 Aug 2025 13:23
06 Aug 2025 13:24

49
50
51
52
1
2
3
4
5
6
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
Tomas Tech All Project Management
FUJI NAME (THAILAND) CO.,LTD
In Progress
New 0%
New 0%
New 0%
New 0%


Also available in: PDF PNG
