Project

General

Profile

Gantt

Filters

Zoom in Zoom out « July | September »

months from Apply Clear

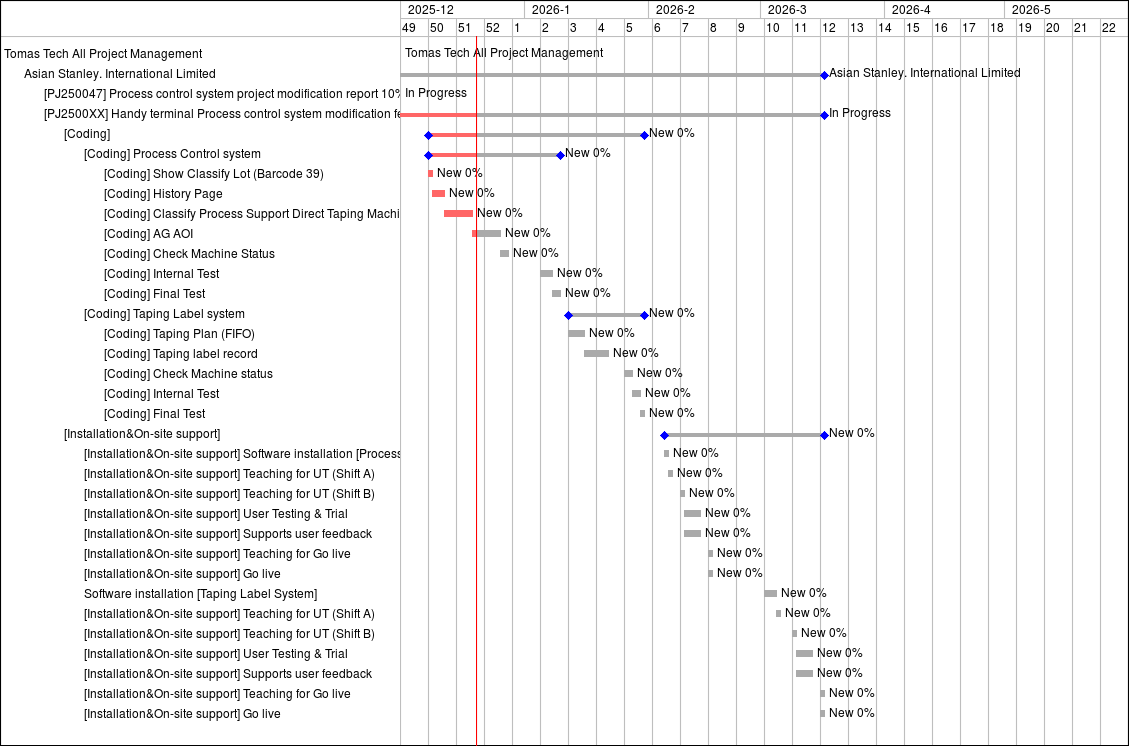

Parent project #1244: [PJ250047] Process control system project modification report 10%
Parent project #3248: [PJ250101] Handy terminal Process control system modification fee
Project progress work #3252: [Coding] Process Control system
Project progress work #3253: [Coding] Show Classify Lot (Barcode 39)
Project progress work #3254: [Coding] History Page
Project progress work #3255: [Coding] Classify Process Support Direct Taping Machine
Project progress work #3257: [Coding] Check Machine Status
Project progress work #3258: [Coding] Internal Test
Project progress work #3259: [Coding] Final Test
Project progress work #3260: [Coding] Taping Label system
Project progress work #3261: [Coding] Taping Plan (FIFO)
Project progress work #3262: [Coding] Taping label record
Project progress work #3263: [Coding] Check Machine status
Project progress work #3264: [Coding] Internal Test
Project progress work #3265: [Coding] Final Test
Project progress work #3266: [Installation&On-site support]
Project progress work #3267: [Installation&On-site support] Software installation [Process Control System]
Project progress work #3268: [Installation&On-site support] Teaching for UT (Shift A)
Project progress work #3269: [Installation&On-site support] Teaching for UT (Shift B)
Project progress work #3270: [Installation&On-site support] User Testing & Trial
Project progress work #3271: [Installation&On-site support] Supports user feedback
Project progress work #3272: [Installation&On-site support] Teaching for Go live
Project progress work #3273: [Installation&On-site support] Go live
Project progress work #3274: Software installation [Taping Label System]
Project progress work #3275: [Installation&On-site support] Teaching for UT (Shift A)
Project progress work #3276: [Installation&On-site support] Teaching for UT (Shift B)
Project progress work #3277: [Installation&On-site support] User Testing & Trial
Project progress work #3278: [Installation&On-site support] Supports user feedback
Project progress work #3279: [Installation&On-site support] Teaching for Go live
Project progress work #3280: [Installation&On-site support] Go live
Parent project #6980: [PJ260055] Handy terminal Process management system Injection and Assy
Project progress work #6981: [Requirement definition]
Project progress work #6982: [Internal Design]
Project progress work #6984: [Installation&On-site support]

Status

In Progress
In Progress
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
In Progress
New
New
New
New

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

96.00
2393.60
1433.60
304.00
8.00
24.00
24.00
40.00
16.00
24.00
16.00
224.00
32.00
32.00
16.00
16.00
8.00
336.00
8.00
8.00
8.00
32.00
32.00
8.00
8.00
24.00
8.00
8.00
24.00
24.00
8.00
8.00
408.00
408.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

19 Jan 2026 14:24
26 May 2026 16:03
30 Apr 2026 15:33
13 Dec 2025 09:49
13 Dec 2025 09:41
13 Dec 2025 09:42
13 Dec 2025 09:44
13 Dec 2025 09:45
13 Dec 2025 09:45
13 Dec 2025 09:49
13 Dec 2025 09:49
13 Dec 2025 09:55
13 Dec 2025 09:51
13 Dec 2025 09:53
13 Dec 2025 09:54
13 Dec 2025 09:54
13 Dec 2025 09:55
26 May 2026 16:03
13 Dec 2025 09:57
13 Dec 2025 09:58
13 Dec 2025 09:59
13 Dec 2025 10:00
13 Dec 2025 10:00
13 Dec 2025 10:01
13 Dec 2025 10:03
13 Dec 2025 10:05
13 Dec 2025 10:06
13 Dec 2025 10:07
13 Dec 2025 10:08
13 Dec 2025 10:09
13 Dec 2025 10:10
13 Dec 2025 10:11
26 May 2026 15:18
18 Mar 2026 09:35
18 Mar 2026 09:35
18 Mar 2026 09:35
26 May 2026 15:18


32
33
34
35
36
37
38
39
40
41
42
43
44
45
46
47
48
49
50
51
52
53
1
2
3
4
Tomas Tech All Project Management
ASIAN STANLEY. INTERNATIONAL LIMITED.
In Progress
In Progress
New 63%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 38%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
In Progress
New 100%


Also available in: PDF PNG
