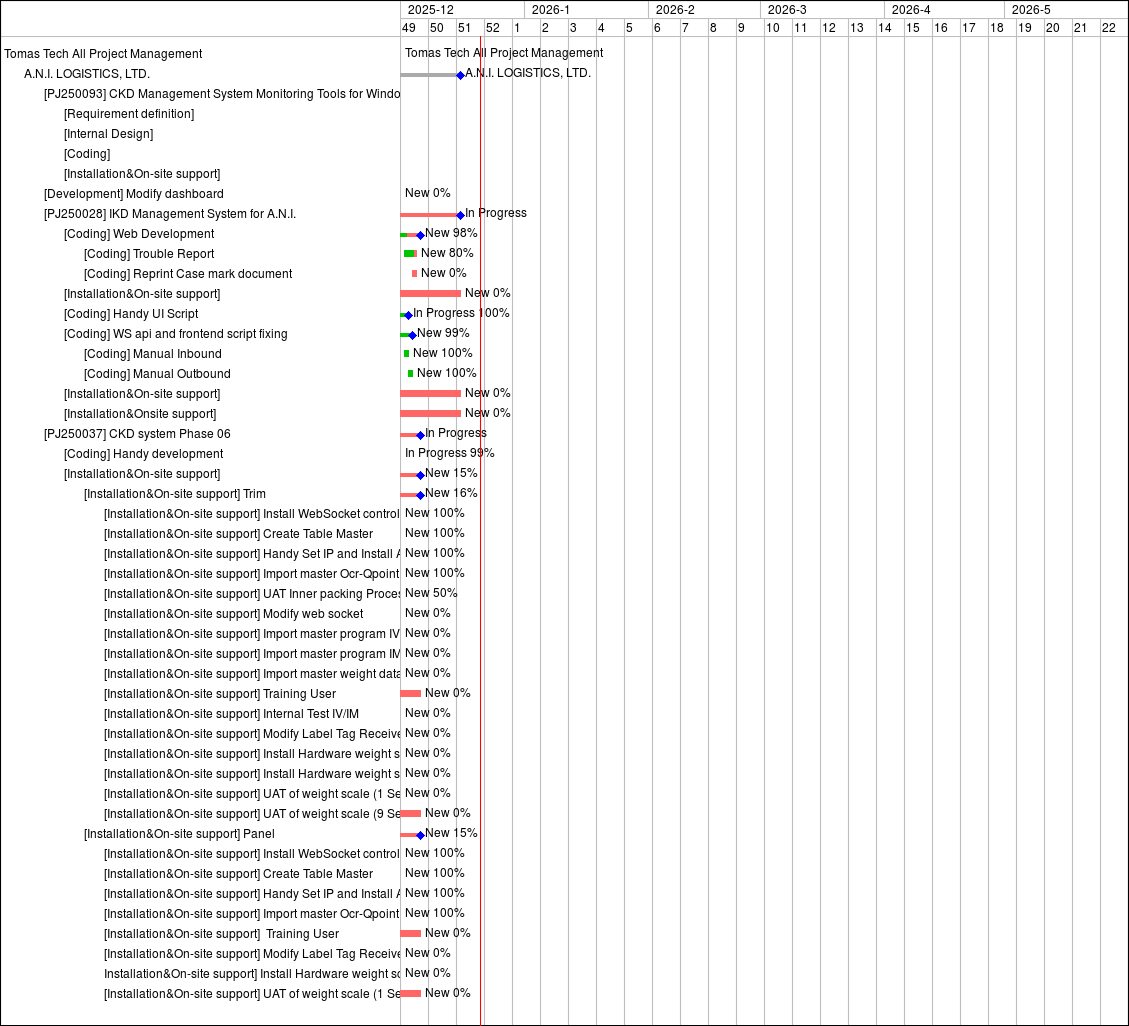

Project

General

Profile

Gantt

Filters

Zoom in Zoom out « March | May »

months from Apply Clear

Parent project #3042: [PJ250093] CKD Management System Monitoring Tools for Windows Server
Project progress work #3149: [Requirement definition]
Project progress work #3150: [Internal Design]
Project progress work #3152: [Installation&On-site support]
Project progress work #637: [Development] Modify dashboard
Parent project #1022: [PJ250028] IKD Management System for A.N.I.
Project progress work #3101: [Coding] Web Development
Project progress work #3138: [Coding] Trouble Report
Project progress work #3135: [Coding] Reprint Case mark document
Project progress work #3148: [Installation&On-site support]
Project progress work #3054: [Coding] Handy UI Script
Project progress work #3072: [Coding] WS api and frontend script fixing
Project progress work #3142: [Installation&Onsite support]
Project progress work #3141: [Installation&On-site support]
Parent project #1058: [PJ250037] CKD system Phase 06
Project progress work #1066: [Coding] Handy development
Project progress work #1067: [Installation&On-site support]
Project progress work #3366: [Installation&On-site support] Supports user feedback
Project progress work #3372: [Installation&On-site support] Teaching for Go live
Project progress work #3376: [Installation&On-site support] Go live
Project progress work #3373: [Installation&On-site support] Pre-Go live for 1line
Project progress work #3374: [Installation&Onsite support] On-line program modification
Project progress work #3375: [Installation&Onsite support] Monitoring program install
Project progress work #3365: [Installation&On-site support] User Testing & Trial (WC)
Project progress work #3364: [Installation&On-site support] SD card installation 8units
Project progress work #1064: [Requirement definition]

Status

In Progress
New
New
New
New
New
In Progress
New
New
New
New
In Progress
New
New
New
In Progress
In Progress
New
New
New
New
New
New
New
New
New
New
In Progress

Priority

Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal
Normal

Total estimated time

0.00
16.00
3158.00
830.00
32.00
8.00
136.00
520.00
32.00
1744.00
240.00
1336.00
120.00
80.00
8.00
8.00
24.00
40.00
8.00
120.00
8.00

Total spent time

0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00
0.00

Updated

09 Dec 2025 08:52
09 Dec 2025 08:52
09 Dec 2025 08:53
09 Dec 2025 08:53
09 Dec 2025 08:54
12 Jun 2024 16:27
11 Mar 2026 14:51
12 Dec 2025 16:59
04 Dec 2025 17:04
04 Dec 2025 17:02
23 Dec 2025 10:02
12 Dec 2025 16:57
11 Mar 2026 14:55
23 Dec 2025 10:01
11 Mar 2026 14:51
05 Mar 2026 15:56
24 Feb 2026 16:16
18 Mar 2026 15:26
23 Dec 2025 15:59
23 Dec 2025 16:04
23 Dec 2025 16:17
23 Dec 2025 16:05
23 Dec 2025 16:06
23 Dec 2025 16:07
23 Dec 2025 14:27
23 Dec 2025 14:19
11 Mar 2026 11:38
05 Mar 2026 15:56


15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
32
33
34
35
36
37
38
39
Tomas Tech All Project Management
A.N.I. LOGISTICS, LTD.
New 0%
In Progress
New 98%
New 80%
New 0%
New 60%
In Progress 100%
New 100%
New 60%
New 100%
In Progress
In Progress 100%
New 88%
New 80%
New 90%
New 0%
New 0%
New 0%
New 0%
New 0%
New 0%
New 100%
In Progress 100%


Also available in: PDF PNG
